Letter: Explanation for proposed $15M cap on Neary renovations

[Ed note: My Southborough accepts signed letters to the editor submitted by Southborough residents. Letters may be emailed to mysouthborough@gmail.com.

The following letter is from Select Board members Tim Fling and Al Hamilton. (For more context, see my prior coverage of the $15M proposal here.)]

To The Editor

A number of people have asked whether the proposed $15,000,000 budget target for extending the life of the Neary School for approximately 15 years (the “Neary 15-Year Plan,” or Deferred Maintenance–Only plan) is sufficient for this approach. This summary consolidates all available expert information into one snapshot. The Neary 15-Year Plan includes the following scope items:

Priority Goals

  • Roof replacement
  • ADA compliance upgrades
  • Fire suppression (sprinkler system)
  • Asbestos abatement
  • Interior finishes (new ceilings and floors after asbestos abatement)
  • HVAC repairs and replacements
  • Masonry and exterior envelope repairs

Stretch Goals (if priority goals are achieved below budget)

  • Kitchen equipment replacement
  • Electrical system updates
  • Site work: paving, sidewalks, drainage
1. Expert Data Available

Let’s look at the data that is available and was completed by experts.

The first is the Vertex Report, done in 2021 for the School Administration. This identified the issues with the Neary school and estimated the cost to address the issues. This includes all the items on the 15 year plan except for a fire suppression and hazmat survey.

The second core report is the SOCOTEC roof estimate that just became available in late January 2026. The updated estimates replace any Vertex estimates from 2021.

2. Consolidated Cost Components

The following sections present:
• SOCOTEC updated estimates (2026)
• Vertex estimates escalated from 2021 → 2025 → 2026
• Items requiring further study (TBD)

Vertex 2021 costs are shown as originally reported and then escalated to a comparable 2025 and 2026 planning basis using cost data provided by the Bureau of Labor Statistics Producer Price Index for Non-Residential Construction. This index measures the increase in construction costs between April 2021 and Nov 2025 (most recent) at 37.2%. Additionally, using an inflation estimate of 7% year-over-year, we can conservatively approximate the cost of the project in late 2026 when work likely would start.  Where newer expert estimates exist (SOCOTEC roof and ADA), those values replace the older Vertex estimations.

Escalation method: Vertex 2021 → Nov 2025 (×1.372), then 2025 → 2026 (×1.07).

2A. SOCOTEC Updated Estimates (2026)

chart from letter - 2A SOCOTEC Updated Estimates (2026)

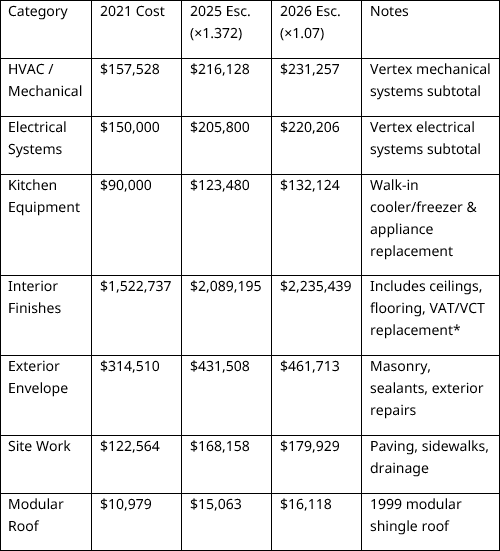

2B. Vertex Estimates – Escalated from 2021 → 2025 → 2026

(Vertex values shown as originally reported, then escalated.)

chart from letter - 2B Vertex Estimates – Escalated

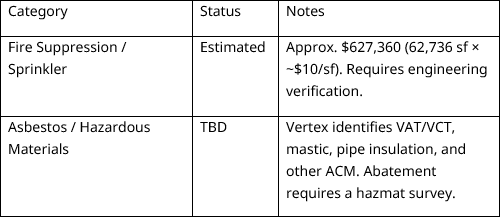

2C. Items Requiring Further Study

chart from letter - 2C Items Requiring Further Study

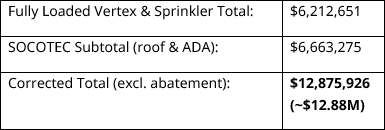

3.Total Costs

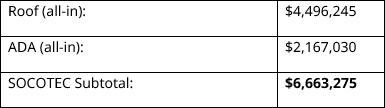

chart from letter - 3 Total Costs (section 1)

SOCOTEC roof and ADA figures shown above are “all-in” totals. They already include design contingency, construction contingency, contractor fees, general conditions, insurance, bond, permitting, and a 10% project-management/soft-cost allowance. These totals do not include hazardous-materials abatement, owner-side soft costs (legal, owner contingency, or FFE), or additional escalation beyond the SOCOTEC calculation date. Because SOCOTEC provides these as fully loaded project values, no additional soft cost or contingency is added in this roll-up.

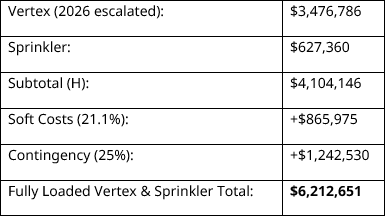

chart from letter - 3 Total Costs (section 2)

The Vertex system-level estimates shown above originate from the 2021 Facilities Assessment and represent construction costs only (hard costs). These values were escalated to 2026 planning dollars using a 37.2% 2021→2025 increase and an additional 7% for 2026. Vertex figures do not include soft costs (design, engineering, permitting, OPM), nor do they include construction contingency or general conditions. Because these items are not embedded in the Vertex values, a 21.1% soft-cost allowance and a 25% contingency are applied to produce a fully loaded planning estimate for this category.

chart from letter - 3 Total Costs (section 3)

(Excludes hazardous materials abatement until a formal hazmat survey is completed.)

*Soft costs (design, engineering, permitting, OPM): 21.1% [This number is derived from recently completed MSBA projects]

4. Summary

The purpose of this exercise is not to produce a final construction budget—this must be completed by design professionals in the next funded phase (to be included as a part of Article 1). Instead, the goal is to determine whether the proposed $15,000,000 placeholder is within a reasonable planning range, to cover both the priority and stretch goals of a 15 year option, based on the best current information. With consideration of the consolidated estimates above, the $15,000,000 planning figure appears reasonable. As additional expert data becomes available, the placeholder should be updated accordingly.

This option would live alongside the other pathways for the town to consider as voters determine what level of investment they have an appetite for. The most urgent and unavoidable capital issues — including the failing roof, fire suppression system, hazardous-materials abatement and ADA compliance items are fully addressed within this scope. However, as outlined in the district’s assessment of Option C2 from the Pre-K to 8 School Building Committee work, this package does not modernize educational or instructional spaces and several areas continue to ‘meet with trade-offs’ in terms of grade-level organization, collaboration spaces and long-term instructional flexibility.

In short, this deferred-maintenance option resolves the most egregious building deficiencies and extends the functional life of Neary, but it does not eliminate all of the structural or educational compromises identified by the district. It would exist as a fiscally lower-impact alternative, allowing voters to weigh the balance between cost, risk reduction and the level of educational modernization they believe is appropriate for Southborough.

Tim Fling (18 Main St)
Al Hamilton (35 Pine Hill Rd)

Footnotes

*Interior finishes include VAT/VCT replacement materials but not abatement. Abatement requires an AHERA‑compliant hazmat survey and professional estimate.

  • ADA total project cost includes SOCOTEC’s design and construction allowances plus project management/soft-cost allowance; it excludes abatement and escalation, and excludes certain owner-side soft costs/FFE/owner contingency.
